Consider the Project Network and Data Shown Below ADetermine the Critical Path

question 23

Essay

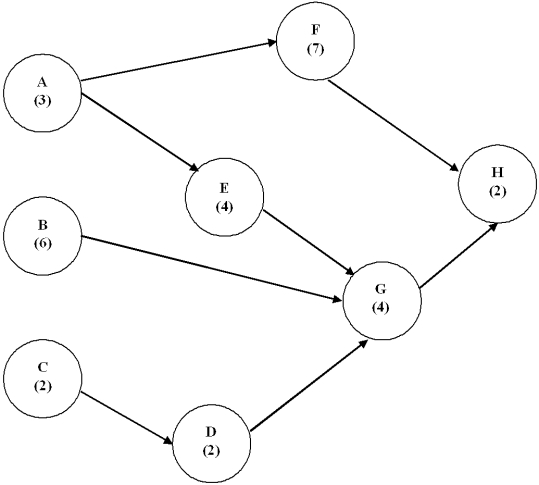

Consider the project network and data shown below:  Consider the project network and data shown below:    \begin{array} { | c | c | c | c | c | c }  \hline \text { Activity } & \begin{array} { c }  \text { Normal Time } \\ \text { Months) } \end{array} & \begin{array} { c }  \text { Crash Time } \\ \text { Months) } \end{array} & \begin{array} { c }  \text { Normal } \\ \text { Cost } \end{array} & \begin{array} { c }  \text { Crash } \\ \text { Cost } \end{array} & \begin{array} { c }  \text { Crash } \\ \text { Cost/ Month } \end{array} \\ \hline \text { A } & 3 & 2 & \$ 100,000 & \$ 150,000 & \\ \hline \text { B } & 6 & 4 & \$ 200,000 & \$ 320,000 & \\ \hline \text { C } & 2 & 2 & \$ 90,000 & \$ 90,000 & \\ \hline \text { D } & 2 & 1 & \$ 180,000 & \$ 250,000 & \\ \hline \text { E } & 4 & 2 & \$ 225,000 & \$ 450,000 & \\ \hline \text { F } & 7 & 6 & \$ 80,000 & \$ 120,000 & \\ \hline \text { G } & 4 & 2 & \$ 310,000 & \$ 500,000 & \\ \hline \text { H } & 2 & 2 & \$ 400,000 & \$ 400,000 & \\ \hline \end{array}   a.Determine the critical path. b.If management wants the project done in one less month, which activity should they crash?  Activity  Normal Time  Months)  Crash Time  Months)  Normal  Cost  Crash  Cost  Crash  Cost/ Month  A 32$100,000$150,000 B 64$200,000$320,000 C 22$90,000$90,000 D 21$180,000$250,000 E 42$225,000$450,000 F 76$80,000$120,000 G 42$310,000$500,000 H 22$400,000$400,000\begin{array} { | c | c | c | c | c | c } \hline \text { Activity } & \begin{array} { c } \text { Normal Time } \\\text { Months) }\end{array} & \begin{array} { c } \text { Crash Time } \\\text { Months) }\end{array} & \begin{array} { c } \text { Normal } \\\text { Cost }\end{array} & \begin{array} { c } \text { Crash } \\\text { Cost }\end{array} & \begin{array} { c } \text { Crash } \\\text { Cost/ Month }\end{array} \\\hline \text { A } & 3 & 2 & \$ 100,000 & \$ 150,000 & \\\hline \text { B } & 6 & 4 & \$ 200,000 & \$ 320,000 & \\\hline \text { C } & 2 & 2 & \$ 90,000 & \$ 90,000 & \\\hline \text { D } & 2 & 1 & \$ 180,000 & \$ 250,000 & \\\hline \text { E } & 4 & 2 & \$ 225,000 & \$ 450,000 & \\\hline \text { F } & 7 & 6 & \$ 80,000 & \$ 120,000 & \\\hline \text { G } & 4 & 2 & \$ 310,000 & \$ 500,000 & \\\hline \text { H } & 2 & 2 & \$ 400,000 & \$ 400,000 & \\\hline\end{array}
a.Determine the critical path.
b.If management wants the project done in one less month, which activity should they crash?


Definitions:

Related Questions
